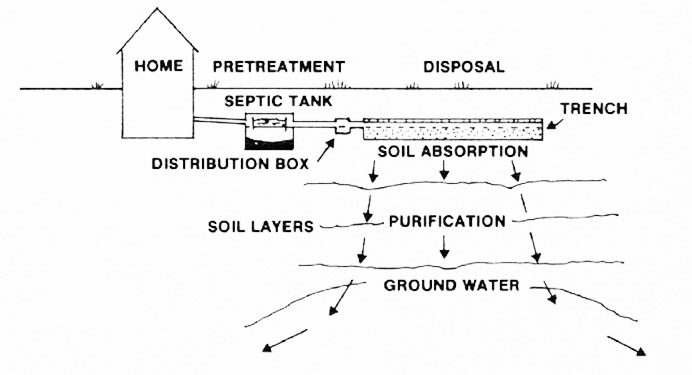

|
Getting a septic system (also called an "on-site sewage system" or "OSS") designed, permitted, and installed can be lengthy. The timeline depends on several factors, such as payment timing, planning requirements, design revisions, and seasonal reviews. In 2025, the average time from submitting a permit application to receiving a design permit (Step 2-4) is about 60 days. We are committed to timeliness and will do our best to keep the process moving as quickly as possible within our limits.
If you are doing any of the following (WAC 246-272A-0200), you will need to take the steps outlined below to get your system installed and approved. A summary is also available here.
- Building a new home or other plumbed structure that will not be connected to sewer.
- Having a repair done that is not a minor repair.
- Replacing your existing septic system.
- Home addition/remodel that requires you to increase the size of your system or alter it.
Depending on your property and what you want to do, there may be more requirements with other regulatory agencies such as Skagit County Planning & Development Services (PDS) in addition to what Skagit County Public Health requires.
Step 1: Hire an OSS Designer
OSS designers will dig soil test holes to analyze your property and design and propose a septic system that meets state and local code. They’ll consider many factors such as the type of soil on your property, the number of bedrooms your structure will have, square footage, and your proximity to a water source. The only people allowed to design septic systems are licensed on-site wastewater designers and professional engineers. We maintain a list of WA State Certified OSS Designers who work in Skagit County.
Step 2: Submit a Permit Application and Pay Fees
Your system designer will submit a permit application, site and soil evaluation, site plan, and their proposed design through Civic Access. Once submitted, the required fees will be calculated and payment requested. Some designers include the permit fee in their services—check with your designer to confirm who is responsible. If the application is incomplete, you and your designer will be notified and corrections can be resubmitted. You may also receive an email indicating that a maintenance agreement is required to be recorded to the parcel.
Step 3: Review by Skagit County Public Health
Upon receipt of a complete application and payment, Skagit County Public Health will begin reviewing the application and design. A determination will be made within 30 days*. It is possible we may consult with your designer, require corrections, and do a site visit to make sure the proposed design will treat wastewater effectively.
*If wet season/winter review (typically November-April) is needed, the process may take up to 12 months.
Step 4: Permit Issued
Once the review is complete and all requirements are met, your design and application will be approved, and you can move forward with hiring an OSS installer. If not approved, you and your designer will receive an email with the required corrections to approve the system.
*Repair permits expire after 1 year; all others expire in 3 years.
Step 5: Hire an OSS Installer
Only installers certified by Skagit County can install your septic system as designed. You can find a list of certified OSS installers here. Gravity-only systems may be eligible to be installed by homeowners. Please review the eligibility criteria and contact us if you are still interested in doing so.
Keep in mind that not all installers work on every system type. For instance, Level 1 installers cannot install Level 2 systems. For more complex designs or site conditions, a pre-construction meeting may be required to review details and address any concerns before the permit is issued.
Step 6: Final Inspection
During the installation, Skagit County Public Health will conduct a final inspection to observe the installed system prior to backfill. Your installer must request an inspection 2 full working days advanced notice. If everything meets requirements, the installer can proceed with final cover. If there are issues, we will work with your installer and designer on the required corrections before covering the system is allowed.
Step 7: As-Built Record
If the system is installed according to the approved design and all tests are successful, your designer or installer will submit an as-built (record drawing) to Skagit County Public Health. We will review the record drawing to confirm its completeness before final approval is granted.
Step 8: Final Approval
After we receive and accept the as-built record, you’ll be notified through Civic Access, and you can begin using your septic system. To keep your system functioning properly, plan for inspections every 1–3 years, pumping as needed, and occasional minor repairs. |
